Testata della pagina

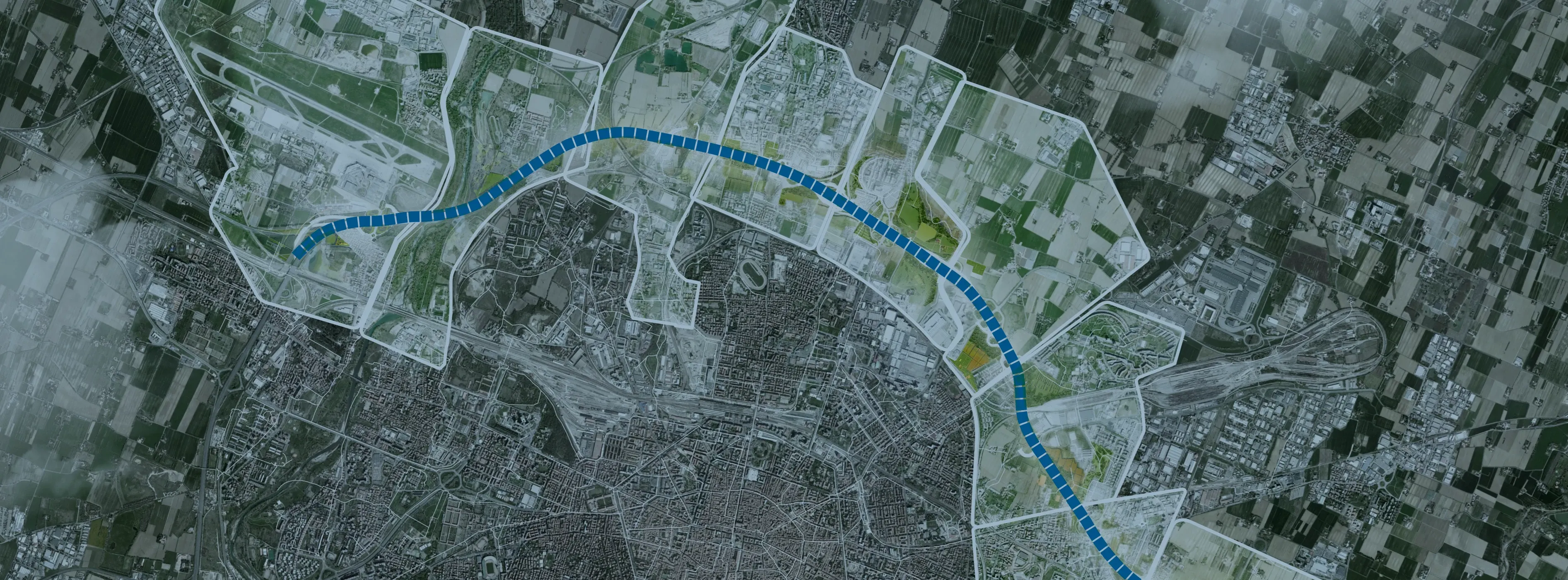

Passante di Bologna

A sustainable mobility model for our country

The Project

An infrastructure born as a “bypass” element for a historically important node for national connections, which is now being transformed into a high-performance motorway section.

It enhances travel experiences and aims to permanently overcome the image of suburbs as residual space as opposed to the city, safeguarding both natural ecosystems and elements of historical and landscape value.

Thanks to the new project of the Passante di Bologna, Reno, Navile and Battiferro canals will once again be fully usable areas, attractive to citizens and safe from a hydraulic and structural point of view.

At Navile and Battiferro, the Passante is an opportunity for a major upgrading project improving the connection between the new parks north and south of the infrastructure, and making the area between the two canals fully usable, encouraging slow mobility, sports, and entertainment.

In addition to eliminating traffic noise, the soundproof tunnel along the bypass is conceived as a reconnecting element, realized through a spectacular roof garden, made up of well-equipped green spaces and fine street furniture, the foundation of a larger reforestation program accessible by a network of new bicycle and pedestrian paths.

The new configuration of interchanges in the San Donnino area includes the replacement of the current flyover with a new deck arranged for the future tram line, and the construction of a new connection road system.

An intervention that preserves the area of through traffic, reduces emissions locally, and promotes slow mobility.



The project in figures

Tecne

the engineering and construction company of ASPI Group

The project is a true green infrastructure and will save up to

70 mln Kg Co2 per year

the project includes the on-site upgrading of the existing A14 Motorway/Ring road system, with



A strategic project for the entire national system, worth more than EUR 1.5 billion, capable of improving the mobility of one of the most critical nodes of the whole Italian motorway network, while simultaneously fluidifying the motorway and urban sections.

The major reforestation works along the route

+

the new fine street furniture

+

the integration of the network of bicycle paths and bicycle and pedestrian walkways

contribute to improving the quality of life for residents.

The first motorway infrastructure in Europe to receive Envision certification with the highest attainable rating level, the Platinum one.

An award that brings a new record to Autostrade per l'Italia, having designed an infrastructure capable of meeting in full the requirements of the international protocol that assessed economic, social, and environmental sustainability throughout its entire life cycle, from the design and implementation to entry into operation.
In the Envision certification, the dual function of the project was evaluated, both the ability to improve the mobility of one of the most critical nodes of the entire Italian motorway network (preserving connections with the motorway network interconnected to major routes, such as A1, A13 and A14), while simultaneously fluidifying the urban motorway section. In fact, upgrading the node will result in travel time reductions of about 4.5 million hours per year; the decrease in travel times and lengths will also generate a decrease in CO2 emissions across the entire metropolitan city, quantifiable at about 1,350 tons per year.
In fact, the Passante was conceived, in agreement with the territory, as a true green infrastructure, a project capable of upgrading the area crossed, increasing environmental endowments and systematically containing noise pollution and atmospheric emissions.

Platinum

Environmental impact

The intervention will implement the development of an ideal “green ring” of about 160 hectares serving as a major environmental/landscape mitigation and inclusion structure for the project, while also expanding the range of usable areas for citizens with 30 hectares of new public parks, planting 34,300 trees and about 60,000 shrubs.

Pattern
  • 30 hectares

    public parks

  • 34.300

    trees

  • 60.000

    shrubs

Timeline

Activity
Duration
GDP Main Activities Focus
2592 d
Basic Design (BD)
367 d
CoS closure
0 d
BD Adjustment and Validation
226 d
MWC/BoD approval for BD submission
15 d
BD submission to MIMS
0 d
MIMS BD Approval
90 d
Construction Design (CD)
270 d
CD development
180 d
CD submission to MIMS
0 d
MIMS CD approval
90 d
Preliminary Activities
545 d
Expropriations - Grant of possession of areas
330 d
Interference Resolutions
365 d
Lot 0 - Start of Preparatory Work
365 d
Ante Operam Environmental Monitoring
365 d
Extension Activities
1710 d
Timeline
20222023202420252026202720282029
JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND JFMAMJJASOND
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •
  •

Expropriations

March 2023

Asset declared as of Public Interest

From 02/2023

Execution of Expropriations - Granting the possession of areas and buildings

October 2022

Transmission of counter-arguments to remarks

July 2022 - August 2022

Receipt of Remarks made by expropriated persons to the project "Passante version 2020" - 2022 update

13/06/2022 - 05/07/2022

Info Point Expropriations at the Municipality of Bologna - 200 owners involved for a total of 245 land registry firms

18/05/2022

Re-publication of the updated Basic Design to obtain the declaration of Public Interest

04/03/2022

Finalization of the State-Region Agreement and introduction of the constraint prior to the expropriation for the Basic Design of the "Passante version 2020" - 2022 update

18/01/2022

Final session of the Conference of Services on the examination of the Basic Design of the "Passante version 2020" - 2022 update

October 2021

Transmission of counter-arguments to remarks

29/07/2021

Third session of the Conference of Services on the examination of the Basic Design of the "Passante version 2020" - project additions and approval of counter-arguments for expropriations requested

October 2020 - February2021

Receipt of Remarks made by expropriated persons to the project "Passante version 2020"

23/09/2020

Initiation of the procedure aimed at introducing the expropriation constraint and approval of the updated Basic Design of the "Passante version 2020" and registration of the project for the convening of the Third Conference of Services

16/06/2020

Second Session of the Conference of Services on the examination of the Basic Design of the "Passante Evoluto" - project changes and "green" additions requested

09/07/2018

Convening of the First Session of the Conference of Services of the "Passante di Bologna" to finalize the State-Region Agreement for 13/09/2018
